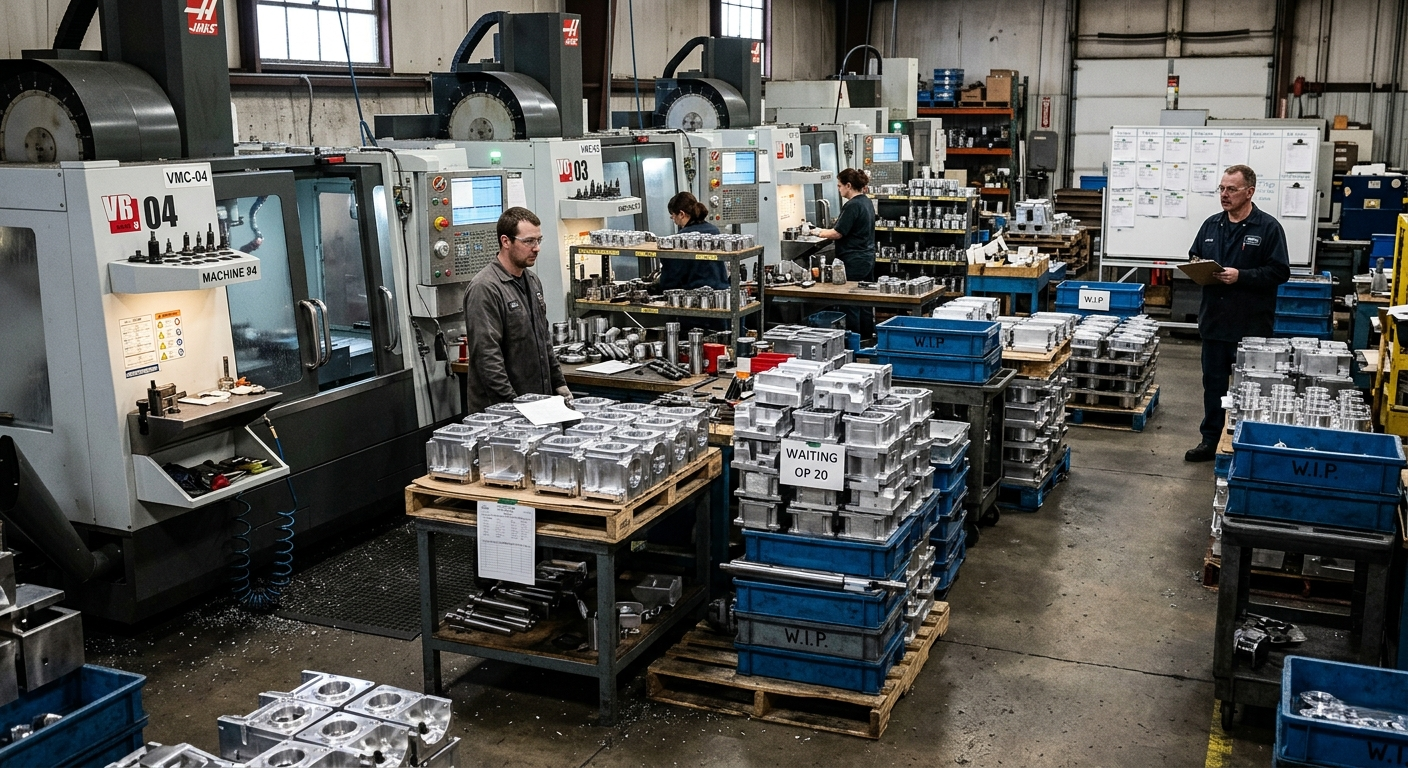

You walk into the shop and everything looks active. Machines are running. Operators are working. There's no idle time.
But jobs are stacked between operations, parts wait days for the next step, and deliveries keep slipping.
That's work-in-progress (WIP) growing out of control. In this guide you'll see why it happens in CNC job shops, what it really costs, and how to reduce WIP in manufacturing with five practical steps you can start this week, without adding machines or people.
What Growing WIP Looks Like on Your Shop Floor
You probably recognise most of these:
- Jobs stacked between operations, on trolleys, pallets and floor space
- Parts waiting for the next step for hours, sometimes days
- You keep getting asked: "Where is this job?" (here's how to answer it without walking the floor)
- Deliveries slip, even though nothing looks "stopped"
- Urgent jobs get pulled out of the pile, which delays everything else
And every week the same thought comes up:
"We're working all day, so why is nothing actually finishing on time?"
So the natural reaction is to push more jobs into production, keep machines running no matter what, and avoid any idle time.
But instead of improving, your WIP keeps growing.
What Most Shops Believe (and Why It Backfires)
Most shops don't see WIP as a system problem. They think:
- "We need to increase utilization"
- "Machines should never sit idle"
- "If we push more work, output will increase"
So they do what feels logical: start jobs early, keep feeding every machine, and let operators pick whatever keeps them busy.
From the outside it looks productive. Inside the system, something else is happening.
Why WIP Keeps Increasing: Your Shop Is a Connected System
Here's the uncomfortable part: keeping everything busy is exactly what's causing the problem.
Your shop isn't a collection of independent machines. It's a connected system, and every job has to pass through its slowest step. When every machine runs at full speed without coordination:
- Faster operations push more work forward
- Slower operations can't keep up
- Work piles up in between
So instead of flow, you get accumulation. You're not increasing output. You're only increasing the amount of work sitting inside the shop.
This push to keep every machine running is often driven by utilization targets that don't reflect what's actually happening. We explain why in Why Machine Utilization Numbers Are Lying to You.
A Simple Example: Turning, Milling and Finishing
Take a shop with three stages. The numbers below are hypothetical, but the pattern is real:
| Operation | Parts per shift |
|---|---|
| Turning | 40 |
| Milling | 25 |
| Finishing | 30 |
Turning is fast, so the team keeps pushing parts through it. But milling can only handle 25 a shift. That means 15 extra parts pile up in front of milling every shift.
Over one week of two shifts a day, that's 150 parts waiting in front of milling. Not one extra part ships, because milling still finishes 25 a shift. Meanwhile:
- Milling operators rush and are still behind
- Finishing gets uneven flow: sometimes waiting, sometimes overloaded
- Turning keeps pushing, because "we can't keep the machine idle"
And look at what happens to lead time. A part that joins the back of a 150-part queue at milling waits 6 shifts (3 working days) before anyone touches it. That waiting time is now part of every delivery you promise.
Nobody planned this. It happens every day.
What Growing WIP Really Costs You
Lead times stretch
Simple jobs take longer. Not because of machining time, but because of waiting time. You can measure it on one real job: where a CNC job really spends its time.
Cash gets stuck on the floor
Every part in WIP has material, labour and machine time already spent on it, and none of it can be invoiced until the job ships. Work out how much with the free WIP calculator.
You lose visibility
You stop knowing what's actually in progress, what's stuck, and what's close to completion. Everything just looks "in process."
Priorities get buried
Urgent jobs don't move faster. They get buried inside WIP. So you interrupt the floor to push them through, which creates more chaos.
If half your open jobs carry an urgent tag, read when every job is urgent for how expediting makes more jobs late and how to get priorities back.
Machines look busy, but output doesn't improve
This is the dangerous one. You think "we're fully utilized," but shipments don't reflect it.
Your team starts firefighting
Supervisors spend the day asking "Where is this job?" and "Why is this not done?", and no one has a clear answer. This is also why your daily production schedule keeps failing: once WIP builds up, planning loses control.
How to Reduce WIP in Manufacturing: 5 Steps for a CNC Shop
You don't fix WIP by pushing harder. You fix it by changing how work moves.
1 Find your slowest operation
Walk the floor and look for the biggest pile of waiting jobs. The operation just after that pile is usually your constraint (bottleneck). It sets the real output of your whole shop. Every other machine can only go as fast as this one.
2 Release work at the pace of that operation
Stop releasing jobs to the floor just because the order arrived or a machine is free. Release new work at roughly the rate your slowest operation can finish it. Jobs that aren't released yet stay as paperwork and raw material, not as half-finished parts blocking the floor.
3 Set a WIP limit in front of the bottleneck
Decide how much work is allowed to wait in front of the slowest operation. A good starting point is about one shift of work. When that queue is full, upstream machines don't start new jobs for it. They do setups, maintenance or jobs for other routes instead.
4 Hold a 10-minute daily priority meeting
Once a day, agree on one priority list, starting with the sequence at the bottleneck. Everyone works from the same list until the next meeting. This stops operators picking "whatever keeps them busy" and stops urgent jobs being pushed in from three directions.
5 Track jobs waiting, not just machines running
Every morning, count the jobs waiting in front of each operation and note how long the oldest one has been waiting. If the queue is growing, release less work. If it's shrinking and the bottleneck is never starved, you can release a little more.
This is the shift: from "keep everything running" to "keep work moving." Accept that some controlled idle time on non-bottleneck machines is healthier than an uncontrolled pile of WIP.
How We Solve This
At KeshRaghTech we don't hand you a generic tool. We start with an Operational Workflow Review to see where work actually gets stuck in your shop. Then we design release rules, WIP limits and priority rules that fit how your shop really runs. We deliver them as a workflow application built around your shop, and coach your team until it's used every day at full capacity.
